A free construction quote template — and a genuinely costed example
A clear quote wins the job; a vague one loses it. Here is the construction quote template we use, free to download and fill in — plus a complete worked example costed by the SangoImmo engine on a real 3-bedroom house.
Download the template
Free, no signup, no email required. Reuse it for your own jobs, including commercially.
What a construction quote must contain
Most quotes that get rejected are not too expensive — they are impossible to check. A client who cannot see what they are paying for assumes the worst. A quote that wins reads like an audit trail:
- Identification — quote number, date, your company details and registration number, the client, and the site address. A quote without a number cannot be referred to later.
- One line per work item, grouped by section (earthworks, foundations, masonry, roof, joinery, plumbing, electrical, floors, finishes). Never a single "construction" line.
- Unit, quantity, unit price, line total on every line. This is the part clients actually check, and the part that protects you when the scope grows.
- Materials and labour shown separately. Labour typically runs 30–40% of materials; hiding it inside the unit price is what triggers the "why so expensive?" conversation.
- Subtotal, VAT, total including tax, then the deposit and the payment schedule.
- Validity date and lead time. Cement and steel move; a quote with no expiry is a promise you did not mean to make.
- What is NOT included — land, servicing, utility connections, permits, contingencies. Exclusions prevent more disputes than any other line.
- Space for the client's signature. An accepted quote is your contract.
What a complete quote looks like (real example)

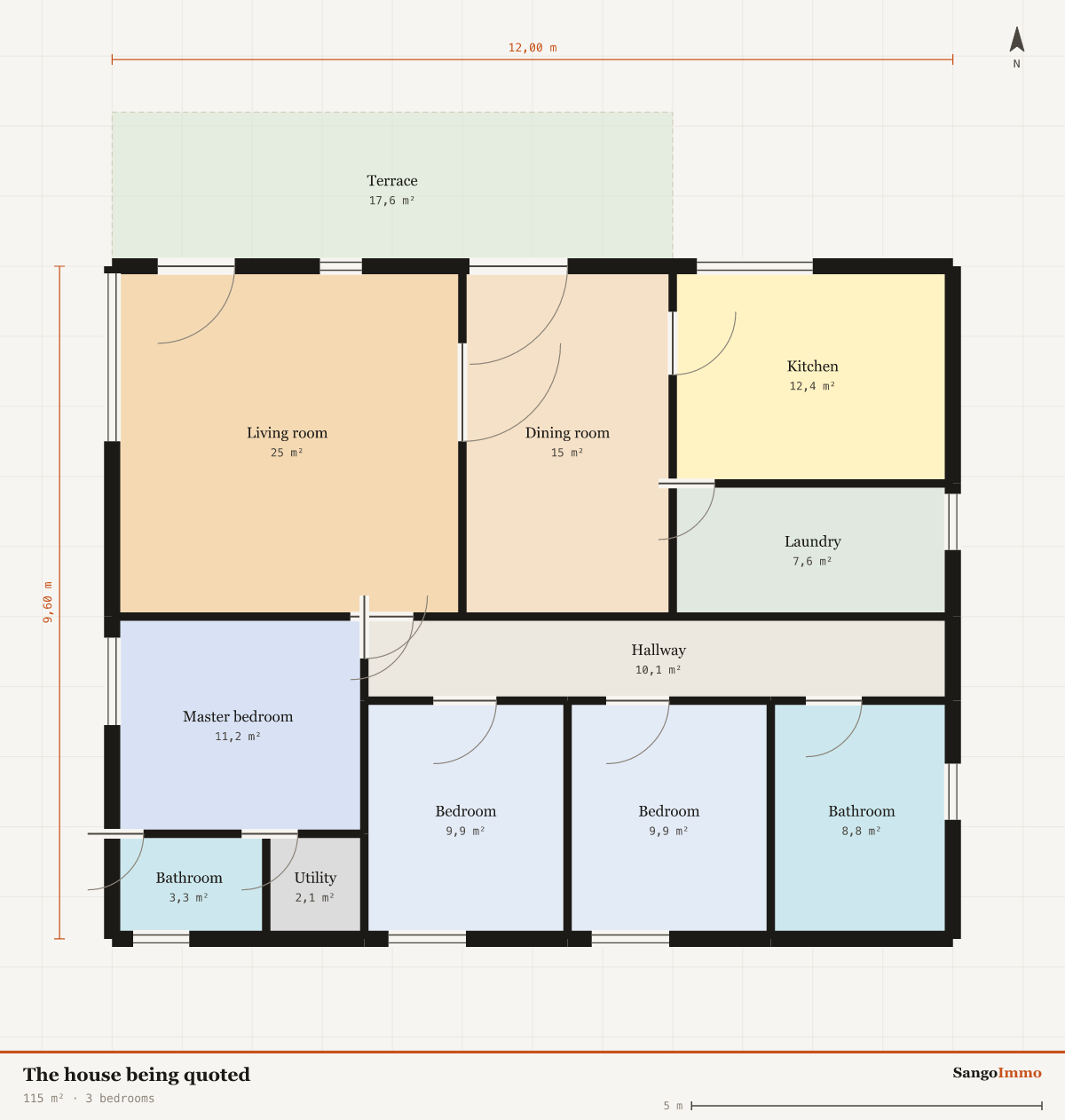

This is not a mock-up. It is the SangoImmo engine's own bill for the published 3-bedroom house plan — 80 priced lines, 115 m², at 2026 Cameroon catalogue prices.

| Section | Description | Qty | Unit price | Total |
|---|---|---|---|---|
| Foundations | Lean concrete | 5,76 m³ | 95 000 FCFA | 500 000 FCFA |
| Foundations | Strip footing (reinforced) | 5,18 m³ | 165 000 FCFA | 900 000 FCFA |
| Foundations | Foundation block 20cm | 34,56 m² | 14 500 FCFA | 500 000 FCFA |
| Foundations | Bottom tie beam (RC) | 43,2 ml | 8 500 FCFA | 400 000 FCFA |
| Foundations | Compacted laterite fill | 17,28 m³ | 12 000 FCFA | 200 000 FCFA |
| Masonry | Hollow block 20 cm | 1247 u | 500 FCFA | 500 000 FCFA |
| Masonry | Hollow block 15 cm | 1479 u | 500 FCFA | 500 000 FCFA |
| Masonry | Cement render (both faces) | 414,22 m² | 3 500 FCFA | 1 400 000 FCFA |
| Masonry | Cement CEM II (50 kg bag) | 163 sac | 6 000 FCFA | 1 000 000 FCFA |
| Masonry | River sand | 7,51 m³ | 14 000 FCFA | 100 000 FCFA |
| Masonry | Crushed gravel 5/15 | 7,65 m³ | 22 000 FCFA | 200 000 FCFA |
| Masonry | Rebar Ø8 (stirrups) | 111,13 kg | 1 000 FCFA | 100 000 FCFA |
| Masonry | Rebar Ø10 | 111,13 kg | 1 000 FCFA | 100 000 FCFA |
| Masonry | Rebar Ø12 | 148,18 kg | 1 000 FCFA | 100 000 FCFA |
| Masonry | Top tie beam (RC) | 78,83 ml | 8 500 FCFA | 700 000 FCFA |
| Masonry | RC post 20×20 | 29,16 ml | 12 500 FCFA | 400 000 FCFA |
| Floors | Concrete slab 12 cm + mesh | 115,2 m² | 16 500 FCFA | 1 900 000 FCFA |
| Floors | Smooth cement screed | 115,2 m² | 4 500 FCFA | 500 000 FCFA |
| Floors | Wood-look tile | 80,96 m² | 17 500 FCFA | 1 400 000 FCFA |
| Floors | Porcelain tile 40×40 | 32,14 m² | 11 000 FCFA | 400 000 FCFA |
| Floors | Tile adhesive (25 kg bag) | 37 sac | 6 500 FCFA | 200 000 FCFA |
| Floors | Tile grout | 90,6 kg | 1 000 FCFA | 100 000 FCFA |
| Floors | Tile skirting | 84,69 ml | 2 000 FCFA | 200 000 FCFA |
| Ceiling | Plastered + painted ceiling | 115,2 m² | 3 000 FCFA | 400 000 FCFA |
| Openings | 6 lines | 1 500 000 FCFA | ||
| Plumbing | 8 lines | 1 300 000 FCFA | ||
| Electrical | 7 lines | 700 000 FCFA | ||
| Finishes | 4 lines | 2 700 000 FCFA | ||
| Sitework & utilities | 5 lines | 600 000 FCFA | ||
| HVAC | 5 lines | 1 100 000 FCFA | ||
| Security | 5 lines | 100 000 FCFA | ||
| Solar power | 5 lines | 0 FCFA | ||
| Fence & exterior | 6 lines | 200 000 FCFA | ||
| Fees & permits | 5 lines | 2 300 000 FCFA | ||
| Materials | 23 100 000 FCFA | |||
| Labour | 7 200 000 FCFA | |||
| VAT (19.25%) | 5 800 000 FCFA | |||
| TOTAL incl. tax | 36 200 000 FCFA | |||
The downloadable CSV contains all 80 lines with every quantity and unit price. Prices are the national 2026 catalogue — replace them with your own suppliers' before sending anything to a client.
Doing it automatically, from the plan
Filling this template by hand takes an evening, and the arithmetic is where quotes go wrong. SangoImmo does the same job from the drawing: sketch the plan (or pick one of the free plans), and the app measures the quantities, prices them at your rates, adds labour and VAT, and exports the quote as a PDF you can send on WhatsApp. Change a room and every number follows. Free to design and cost, works offline.
Frequently asked questions
- Is this quote template really free?
- Yes — download it, use it, modify it, including for paid work. No signup, no email, no watermark.
- Does it open in Excel?
- Yes. It is a CSV file with a UTF-8 byte-order mark and semicolon separators, which is the combination Excel opens correctly on French and African locales. It also opens in LibreOffice, Google Sheets and mobile spreadsheet apps.
- What percentage should I add for labour?
- On the projects this engine costs, labour runs about 35% of the materials total, but it varies by trade and by city. Show it as its own line rather than folding it into unit prices — clients trust a quote they can take apart.
- How do I avoid quoting too low?
- Quantities are where money is lost, not unit prices: an underestimated wall area costs you the same margin twice, in materials and in labour. Measure off a plan rather than from memory, add a contingency line, and state your exclusions.
Sources and references
- Figures: SangoImmo costing engine, 2026 materials catalogue — see the full methodology. Open data, CC BY 4.0.
- National statistics and price indices for Cameroon: Institut National de la Statistique du Cameroun (INS).
- Housing policy and building permits: Ministère de l'Habitat et du Développement Urbain (MINHDU).
- Compliance rules checked by the app: SANS 10400 (building regulations), French NF DTU codes of practice, CEMAC-region practice.
Stop retyping quotes
Draw the job once; SangoImmo produces the takeoff, the quote and the invoice — free and offline.
Launch SangoImmo — freeor try the quick cost calculator
